Task 09 · QC Stability Scientist
Review the 24-month stability-testing workbook
Review the colleague’s testing-plan workbook as the lab’s quality reviewer and leave it ready for others to act on.
GPT-6.1 Sol caught 8 of 15 traps. See which →
3What just happened?
The 24-month shelf-life samples are due 18 October 2026, and the plan for testing them needs sign-off.
A colleague built a workbook planning which samples to pull, which machines and methods to use, and when results go to Quality and the regulator. Nothing starts until the lab’s quality team approves it.
Workspace cutoff date: 27 September 2026.
4Who has to do what?
Review the colleague’s testing-plan workbook as the lab’s quality reviewer and leave it ready for others to act on.
- The seat
- Viktor Takacs, QC Stability Scientist
- What a good answer looks like
- It records who decided what, keeps the original entries, catches every expired or lapsing item, and turns each problem into an owned, dated action.
- What must be handed in
STB-AVI401-002_24M_pull_and_update_control.xlsx
The assignment as the model received it
Viktor — Tomas has left the STB-AVI401-002 24-month pull and regulatory handoff control workbook in his working folder for QC functional approval. Quality needs one dependable control package before the pull is authorized and before verified data move onward to QA and Regulatory. Bring Tomas’s workbook through QC review and leave it ready for the accountable functions to act on. Work in place in _Working/Tomas Li/STB-AVI401-002_24M_pull_and_update_control.xlsx: preserve Tomas’s baseline entries, use the workbook’s QC fields and cell comments for send-backs, record the actions and evidence needed to close them, and leave an attributable final QC disposition. Keep the review in that working copy rather than creating a second package. Do not alter source records or update LIMS, RIM, DMS, QMS, or any other governed system.
5Which files decide it?
The planning workbook, equipment and calibration records, reference-sample records, the regulator’s questions, and the lab-error record.
The model also has the rest of the company’s shared drive, its chat and its record systems. Finding the right files is part of the job. Flip through the key ones below.
Company documents
Some of the documents available to the model.

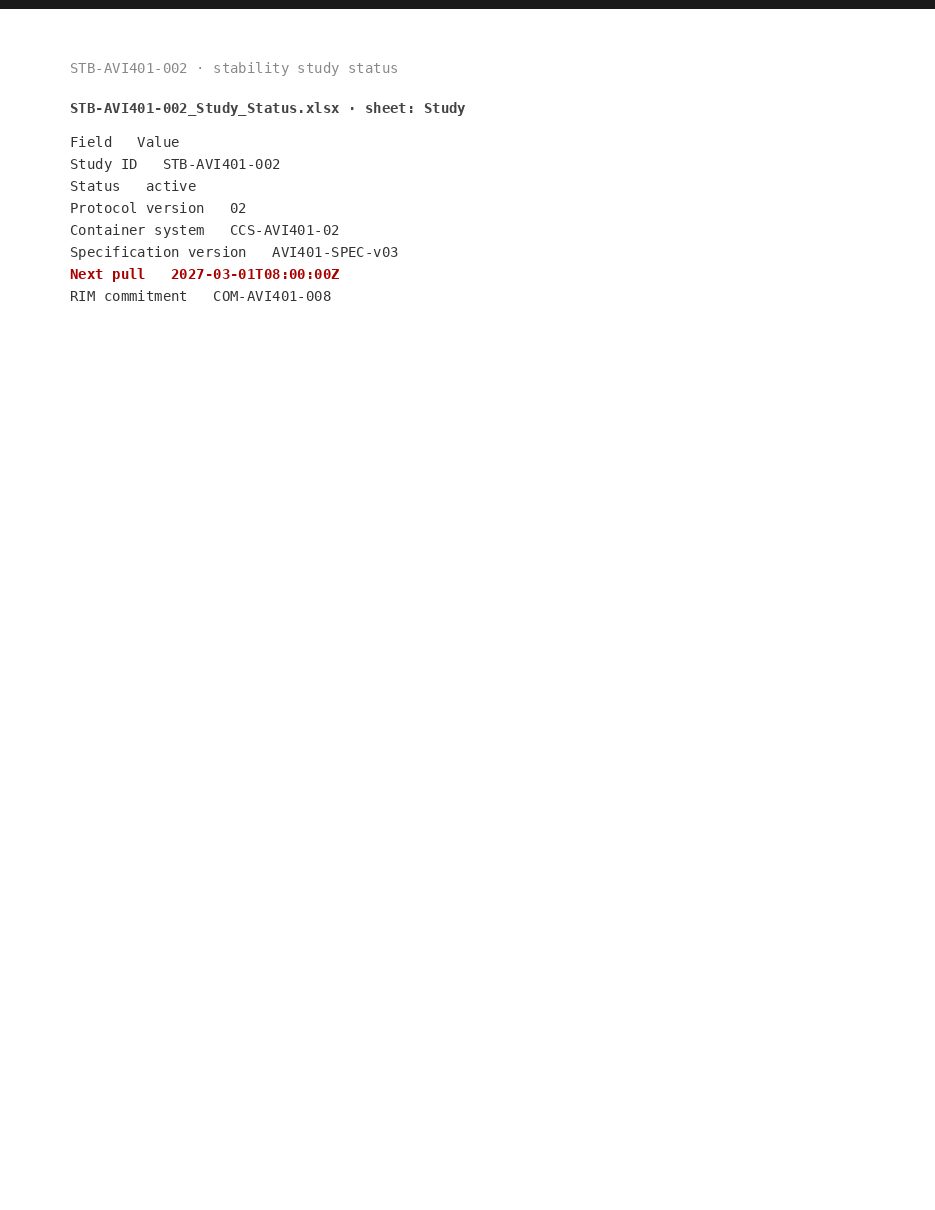

The next results do not exist yet
The company date is 27 September 2026. The pull schedule distinguishes completed laboratory work from the next planned measurements.
An agent can prepare the update now, but cannot present the scheduled 24-month results as already reported.

6What did the model do?
What GPT-6.1 Sol did, step by step.
In short: Sol preserves Tomas’s baseline entries, catches the chamber requalification lapse, the reference-standard expiry, and the calibration boundary, and reconstructs the testing chain required for the campaign.
Step 6. Locates Tomas Li's 24-month control workbook and source records. Sol finds the working Excel control package alongside the chamber qualification, reference-standard, calibration, and stability records.
Tool call recorded in sessiontext(await tools.exec_command({cmd:"pwd && rg --files -g 'AGENTS.md' -g '*.xlsx'
Step 16. Audits the chamber requalification and reference-standard dates. Sol checks the equipment and standard records, catching that chamber CHM-25-03's 36-month requalification lapses on 17 October 2026 and that RS-AVR-014 expires on 5 November 2026.
Tool call recorded in sessiontext(await tools.exec_command({cmd:"cat > /tmp/avi401-qc/ocr.py <<'PY'\nfrom pat
Step 28. Updates the workbook in place, leaving lot-mapping and timeline gaps. Sol preserves Tomas's baseline cells and records QC send-backs, but misses the R01/R02/R03 bag-size mapping error and does not enforce one consistent timeline across all seven authority questions.
Tool call recorded in sessiontext(await tools.exec_command({cmd:"python3 - <<'PY'\nfrom pathlib import Path\n
Bears on: Every fix needs an owner and a deadlineFix the batch-to-bag-size mix-upA separate go/no-go for each stepOne timeline that adds up
Replay every step of the run →
Inside the run
Locates Tomas Li's 24-month control workbook and source records
text(await tools.exec_command({cmd:"pwd && rg --files -g 'AGENTS.md' -g '*.xlsx'
Sol finds the working Excel control package alongside the chamber qualification, reference-standard, calibration, and stability records.
7Which traps did it catch?
It caught 8 of 15.
Specialists wrote these checks from the records in the workspace. Each is a weak spot a reviewer or inspector would find. A check passes only when the submitted file provides the required evidence.
Missed
Every fix needs an owner and a deadline R03
Each problem sent back must name one responsible person, a due date, what it blocks, what evidence closes it, and exactly where that evidence lives.
If missed, problems get flagged but never closed.
Fix the batch-to-bag-size mix-up R04
Two test batches are 100 mL bags and one is a 250 mL bag. The workbook wrongly lists a 250 mL and a 500 mL batch; there is no 500 mL batch.
If missed, the wrong bags get tested and the worst case is never checked.
A separate go/no-go for each step R05
Pulling samples, each test, locking the data, and handing off to the regulator each need their own consistent conditions.
If missed, one step starts before what it depends on is ready.
One timeline that adds up R10
The pull stays 18 October. All tests finish before the data lock, so a complete dataset can’t be ready for the 6 November response.
If missed, the company promises the regulator data it can’t deliver.
Answer all seven regulator questions R11
The regulator asked seven numbered questions, including a small one about the filing’s page layout. Each needs an owner, the evidence required, and a route back to the regulator.
If missed, an unanswered question delays approval.
Demand a checked shelf-life calculation R12
The shelf-life answer needs an independently checked, per-batch calculation with projections and confidence limits.
If missed, an unchecked calculation goes to the regulator.
Cite the current wrapper’s oxygen evidence R15
The answer needs the approved wrapper’s oxygen barrier at storage conditions and the oxygen inside the bags, with exact citations, not the proposed new film.
If missed, the regulator gets evidence about the wrong wrapper.
Caught
Sign and date the review honestly R01
The review is recorded under the reviewer’s name as of today (27 Sep 2026), without back- or forward-dating and without claiming to have changed official systems.
If missed, nobody can tell who decided what, and when.
Don’t erase the original entries R02
Corrections go into review columns and comments, so the colleague’s original entries can still be seen.
If missed, the trail of what was first proposed is lost.
The storage chamber’s approval runs out R06
The chamber holding the samples is calibrated until July 2027, but its separate qualification ends 17 October 2026, the day before the samples are due.
If missed, the samples sit in an unqualified chamber and their results can be challenged.
A reference sample expires mid-campaign R07
The reference sample expires 5 November 2026. It can support the strength tests planned for 1–4 November, not the impurity tests planned for 8–12 November.
If missed, the impurity results are measured against an expired reference.
An instrument’s calibration ends before use R08
The leak-test instrument was calibrated 29 November 2025 for 12 months, so it is out of calibration for its planned use on 30 November–1 December 2026.
If missed, the leak-test results are invalid.
List the complete testing chain R09
Every test in the specification needs its storage chamber, method, instrument and reference sample listed, and nothing unrelated.
If missed, a test can start with an unqualified piece of the chain.
“Within the limit” doesn’t settle it R13
An accelerated-test result of 0.46% is under the 0.50% limit, but conflicting records mean someone must still formally decide whether it counts as a “significant change”.
If missed, a formal regulatory question is waved away.
Did the lab error hit other tests? R14
A past test run was thrown out because of a mixing mistake. The record needs the cause, the replacement result, and a check of whether the same mistake affected other runs.
If missed, other results made with the same mistake stay on file.
Every model on the same job
One published attempt each, on the same assignment and checklist, so treat small gaps as noise.
- GPT-6.1 Sol · shown above8 / 15Run →
- Claude Opus 5.54 / 15Run →
- Claude Fable 5.16 / 15Run →
- GPT-6 Astra7 / 15Run →
Scores on this page are from the published biopharma-bench@v0.2 package (130 checks across these ten tasks).
Workbook changes
STB-AVI401-002_24M_pull_and_update_control.xlsx
Selected cells before and after the model’s edits. Longer entries are shortened here.
Control11 changed cells
| Cell | Baseline | Submitted entry / excerpt |
|---|---|---|
| C2 | Blank | Tomas Li baseline retained; corrections are requested in QC fields/comments and Review Actions. |
| C3 | Blank | QC review performed 2026-11-07 UTC. September source snapshots do not establish actual October/November execution. |
Pull Plan18 changed cells
| Cell | Baseline | Submitted entry / excerpt |
|---|---|---|
| G2 | Blank | HOLD / SEND BACK |
| H2 | Blank | AVI401-R01 is 100 mL per the controlled Lots table. Presentation identity agrees. Common chamber requalification ends at the 2026-10-17 anniversary, before the nominal 2026-10-18 pull. No executed pull/receipt record is supplied. Baseline a |
Execution Sequence54 changed cells
| Cell | Baseline | Submitted entry / excerpt |
|---|---|---|
| G2 | Blank | HOLD / SEND BACK |
| H2 | Blank | Annual calibration (MER-2026-2894, performed 2026-07-17, due 2027-07-17) does not renew chamber requalification. AVT-VAL-341 performed 2023-10-17 + 36 months = due 2026-10-17; pull follows on 2026-10-18. Storage continuity and actual sample |
Chain and Controls228 changed cells
| Cell | Baseline | Submitted entry / excerpt |
|---|---|---|
| G2 | Blank | HOLD / REQUALIFICATION GAP |
| H2 | Blank | Governing activity is requalification under AVT-SOP-045, not annual calibration. AVT-VAL-341 performed 2023-10-17 → due 2026-10-17 (36 months). MER-2026-2894 calibration due 2027-07-17 does not extend that state. Earliest chain boundary pre |
Regulatory Handoff36 changed cells
| Cell | Baseline | Submitted entry / excerpt |
|---|---|---|
| G2 | Blank | SEND BACK / DEADLINE RECONCILIATION |
| H2 | Blank | Letter dated 2026-09-07 requests written response within 60 days → 2026-11-06. Item 7 separately asks for verified 24M data as next COM-AVI401-008 update; no earlier pull requested. Complete 24M set cannot be locked on 11-05 with impurities |
Review Actions135 changed cells
| Cell | Baseline | Submitted entry / excerpt |
|---|---|---|
| B2 | Blank | Pull Plan!B3/B4/H2:H4; Control!C4:C5; Regulatory Handoff!H4 |
| C2 | Blank | Correct R02 to 100 mL and R03 to 250 mL in author follow-up; use AVI401-SPEC-v03 / AVT-SPEC-018 v03. AVT-SPEC-024 is AVI-401-PFS. AVT-STB-301 is current 18M summary; AVT-STB-302 is superseded. |
QC Disposition11 changed cells
| Cell | Baseline | Submitted entry / excerpt |
|---|---|---|
| B2 | Blank | SEND BACK / NOT APPROVED — final QC working-copy disposition; review complete, action closure pending. |
| B3 | Blank | 2026-11-07 UTC |
